Best Of
Re: Share your annual rollover best practices — Community Q&A Challenge
How to Properly Execute an Annual Rollover in Anaplan
An annual rollover in Anaplan doesn’t have to be a stressful, high-risk process. When approached with structure, foresight, and automation in mind, it becomes a predictable and controlled operation. The key is not just what you do during the rollover, but how well you’ve prepared throughout the year.
Below is a practical framework, based on real-world best practices that I have developed over the past 13 years in Anaplan, and it really helps ensure your rollover runs smoothly every time.
1. Maintain a Living Rollover Checklist
One of the most effective ways to de-risk your annual rollover is to maintain a centralized, sequential checklist, ideally within each model or in a dedicated administrator model.
This checklist should include:
- Time settings updates (model calendar changes)
- Time range adjustments
- Version updates
- Required actions and processes
- Pre- and post-rollover validation reports
The most important part: keep it updated continuously.
As models evolve, small enhancements often introduce new dependencies - especially ones that impact time, versions, or data structures. These changes are easy to overlook during rollover preparation and can cause unexpected failures or data inconsistencies.
A well-maintained checklist ensures:
- Nothing gets missed
- New dependencies are documented as they’re introduced
- The rollover process becomes repeatable and scalable
2. Automate the Rollover Process (Especially Data Cleanup)
Automation is where you move from a reactive to a proactive rollover strategy.
Whenever you design data flows into your model, think in three dimensions:
- How do I load this data?
- How do I structure it?
- When (or if) should I delete it?
That third question is often overlooked, but it’s critical.
Smart Data Retention Strategy
Not all data should be treated equally:
- Metadata → typically retained indefinitely
- Transactional data (e.g., FP&A actuals) → often only needed for active planning horizons.
For example, you likely don’t need to store detailed income statement transactions for years that no longer exist in your model calendar.
Implementing Delete Logic
To handle this cleanly:
- Add a boolean flag in your SYS modules that identifies records with no associated time period
- Use this flag to drive delete actions
You can then:
- Run deletes individually (for initial validation), or
- Bundle them into a single automated process once confidence is established
Make It Visible
Surface this logic in a dashboard (or UX page) that includes:
- Your rollover checklist
- A preview of records flagged for deletion
- Controls to execute cleanup actions
This transparency builds trust and allows stakeholders to validate what will happen before the rollover is executed.
3. Perform Critical Sanity Checks
Even well-designed models can behave unexpectedly when time shifts. A few targeted checks can prevent major issues.
Watch for PREVIOUS() Dependencies
Formulas using PREVIOUS() can produce incorrect results when the input source periods no longer exist.
Recommended approach:
- Create an import action that overrides the first period of the new model calendar
- Populate it with values from the last period being removed
This ensures continuity in calculations and avoids gaps in logic.
4. Always Backup Before You Begin
Before initiating any rollover steps:
- Copy or archive the model
Best practice:
- Keep a copy within the same workspace for easy comparison
This allows you to:
- Run side-by-side validations
- Compare pre- and post-rollover outputs
- Quickly recover if something goes wrong
Think of this as your safety net—it’s simple, but absolutely essential.
5. Validate Before and After the Rollover
A proper rollover isn’t complete without validation.
Pre-Rollover
- Confirm current data integrity
- Snapshot key reports
- Validate totals and balances
Post-Rollover
- Re-run the same reports
- Compare results against pre-rollover snapshots
- Confirm:
- Time settings updated correctly
- Data cleanup behaved as expected
- Calculations remain accurate
Final Thoughts
Annual rollovers in Anaplan shouldn’t feel risky or unpredictable. The complexity often comes from lack of documentation, missing automation, and overlooked dependencies - not the rollover itself.
If you:
- Maintain a living checklist
- Build intentional data deletion logic
- Automate repeatable steps
- Perform targeted sanity checks
- Always backup and validate
…then your rollover becomes a routine operation rather than a fire drill.
Invest the time upfront, and future you (and your stakeholders) will thank you.
How I Built It: Dynamic driver-based planning
Author: Chris Allen is a Certified Master Anaplanner and Manager at Allitix part of Accenture.
Hi Anaplan Community!

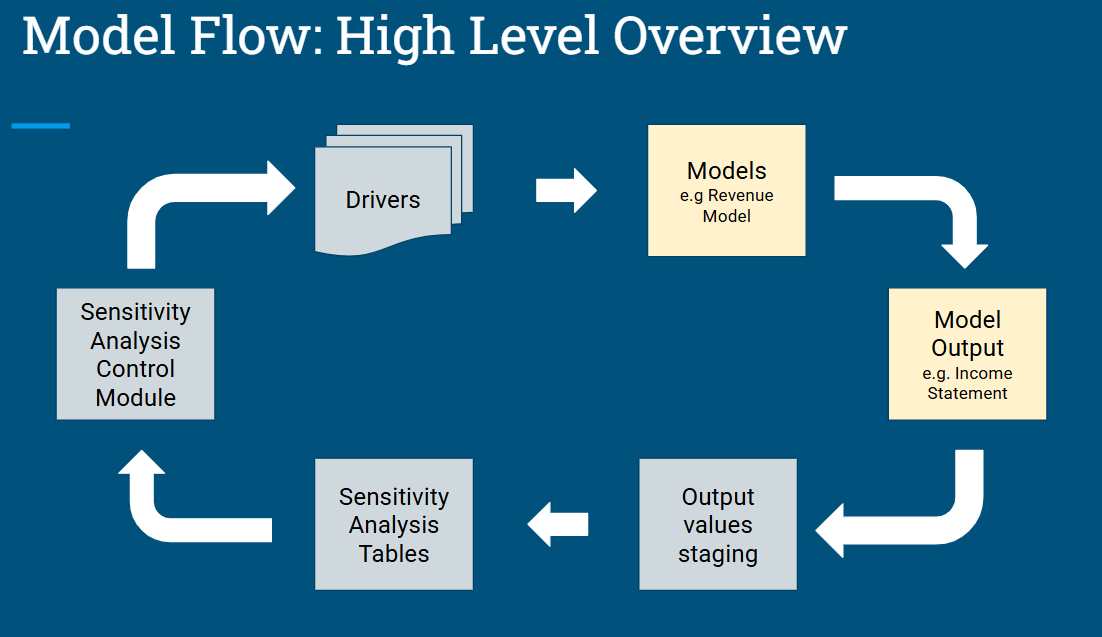

This ‘How I Built It’ video shares a dynamic feature to toggle between different planning methodologies corresponding to different lines on the P&L for driver-based planning.
It's a feature that can be applied to many different scenarios where a list item has unique line items related to it than its peers in the same list — to only show the related line items per the list item selected. The upside is decluttering a dashboard and allowing a good fit on one screen without much searching or scrolling.
Check it out and leave a comment with questions!
……………
Check out my other ‘How I Built It’ videos:
Re: Change the model source for all pages in an application in one go
Have you seen this?
Re: Freeze Panes by Default on UX Pages
This would be a very easy win and mark a huge improvement to how the Freeze Grids functionality works.
Understanding that grid "transforms" are stored in the browser's local storage to allow for persistence across page changes — something as simple as a "Default No. of Columns Frozen" selector in the Column Settings section of Grid edit, could then be used to generate a default Transforms entry (if no existing local user transforms are found)
Re: Freeze Panes by Default on UX Pages
This feature would be really useful, especially with the introduction of combined grids
Re: Anaplan Data Orchestrator (ADO) outbound connectivity
Its going to be available by this month end in Anapedia, as we plan to GA this by then
ReenaS
Create export template for Anaplan users to import using months
Author: Tyler Beck is a Certified Master Anaplanner at TBLB LLC, and is currently a Team Lead at CVS Health.
Use case
An end user needs to export a template from Anaplan using Months as the time period in columns, and qualitative data in rows. When the template is exported as a CSV file the years in the dates turn to days instead of years in the Excel file. The import will result in error when mapping back to native time in Anaplan due to the date change.
Use case example
The module below is exported from Anaplan as a CSV file:
The CSV file is opened and the dates show the years as days, and the years are recognized as the current year DATE() in Excel as a default setting:
The dates in the CSV file will show a format of MM-DD-YYYY instead of the Anaplan format of MMM-YY. This is a major issue for clients who need to export a template to lookup the most recent data when manually inputting data is not feasible due to large data sets. When the CSV file is loaded back into Anaplan, the module will import the data into the wrong months or result in an error all together:
The import shows the error for “Invalid date or timescale identifier” because the expected native time years are shown as days in the CVS file.
Solution
Create a “Dynamic Time” production list in Anaplan apply it to the columns in a new export module as a template. Then import the template back into the input module’s native time using the custom fixed position pattern in the import configuration.
Solution example
- Create “Dynamic Time” as a production list so the dates can be changed in the Production environment: The list should include a special character in front of the MMM-YY month format that Anaplan uses for native time. The list in this example will use an apostrophe as the special character, and two years are applied to the list. More than two years can be applied to the list, and subsets can be made for forecast and plan months as well.
- Apply Dynamic Time list to module and export the template for users to update values: The export template should have all mapping qualitative data fields in rows and Dynamic Time in columns, and include empty rows so end users can create lookups for the data: Also, remember to include the labels and update the “Name” to “Code” for the dimension in the rows: Using codes will not only make using lookups easier in Excel, but is also more efficient for loading back into Anaplan by mapping codes to the dimensions. Placing a special character in front of the native time period format will prevent the CSV file from defaulting to Excel’s MM-DD-YYYY format and now can be mapped to Anaplan’s native time.
- Create an import for the template using a custom fixed position pattern:
Map the codes to the correct dimensions, time as column headers, and the amount as a fixed line item.
Next, select the Time tab in the import configuration and select Periods for the timescale, then navigate to the custom fixed position pattern section and enter ?MMM-YY. Placing a “?” in front of the MMM-YY format will tell Anaplan to ignore the special character so the format will map back to native time. - Run Import with new configuration to import the template into native time: The import is now successful, importing all fields with no errors. All values have been mapped to the correct dimensions in the correct native time period.
Conclusion
Creating an export template using a production flat list can allow end users to export a template to populate data to import back into Anaplan by placing a special character in front of the month names. This will allow end users to bulk upload large data sets when manually inputting the values is time consuming and tedious. Remember to always export the template to include all rows and to show labels, as well as changing the “Name” in the label to “Code” so numbered lists can be mapped seamlessly.
tbeck
Re: Workarounds for coercing timescales in Polaris?
What are the ratio settings in Step 1? I'm not following how Quarter results in 2
cmahaffy
Re: Lookup parent values in a non-composite (ragged) hierarchy
Completely agree. as I've learned more about Anaplan, I found ragged hierarchies to be incredibly powerful & efficient. There are other frustrating quirks about ragged hierarchies (e.g. when building the structure you have to use the name of the parent rather than the parents code) that I wish anaplan would look into.
As you say this one is particularly irritating as the value is there but simply not retrievable in a dynamic (lookup) way.
tscott
Re: February 2026 platform releases and what’s next
Thank you for the updates.
When it comes to the ADO, would there be any plans to make ALM management easier when using Anaplan Data Orchestrator (also referring to the thread here: https://community.anaplan.com/discussion/160019/true-alm-for-anaplan-data-orchestrator)?
Thank you!
